Learn when a corporate project needs specialist management, how to assess risk and when to engage a project manager to control cost and delivery
When does a corporate real estate project become high-stakes?
A high-stakes corporate real estate project is defined by consequences of failure: business interruption, employee disruption, regulatory noncompliance, leadership exposure or reduced asset value.
The shift from routine to high-stakes is not always clear at the outset. A lease renewal, floor refresh or small consolidation may run well with a familiar team and established contractors, but projects carrying operational, financial or regulatory consequences require a different delivery model and specialist project management.
There are signs of a high-stakes project that should prompt a closer review of a project’s governance, expertise and internal capacity, and engaging the right support early offers more opportunity for your team to shape the site, scope, budget and procurement strategy before major commitments are fixed.
Six signs a project may need a different delivery model
- The project has executive or board attention. Senior-level visibility increases the need for clear accountability, reliable reporting and early escalation of cost or schedule risks.
- The deadline is fixed. Lease expirations, business consolidations, capital cycles, product launches and regulatory milestones create dates that the project team may have little power to change.
- People or business operations will remain on-site. Work in an occupied setting requires careful phasing, access controls, safety planning and communication. A delay or sequencing error can affect more than the construction area.
- The project requires specialist knowledge. Cleanrooms, trading floors, automated distribution facilities, data-dense environments and regulated spaces require technical knowledge that may sit outside a general workplace delivery model.
- The project spans multiple locations. Multi-site project management requires governance that individual project's don't need. Without it, cost benchmarks, delivery standards and accountability can vary from one market to another.
- Failure would affect operations, compliance or asset value. A project warrants greater oversight when the cost of failure extends beyond the construction budget.
Why 2026 market conditions have raised the stakes
Most organizations underweight risks of current market conditions surrounding a project. Construction cost escalation, material pricing, contractor capacity, regional variation and technology requirements all affect how budgets and schedules should be set.
Higher fit-out costs increase the value of early cost control
The average medium-quality corporate office fit-out cost in the United States and Canada is approximately $295 per square foot. Costs vary by market, and year-over-year escalation ranges from 3% to 10%.
At the $295 benchmark, a 100,000 square-foot project has an estimated fit-out cost of $29.5 million. A 5% overrun would add approximately $1.5 million.
That exposure makes the quality of the original scope, cost baseline and change-control process more consequential. A budget based on old benchmarks or incomplete technology requirements can create problems before design begins.
Material pricing may not be fully reflected in early bids
Material costs remain exposed to changes in trade and tariff policy. Our High-Stakes Projects Guide cites aggregate price increases of approximately 8% above 2024 levels, with some materials potentially increasing by 5% to 25% depending on policy developments.
Projects in planning or preconstruction should account for escalation that may not be reflected in an initial contractor quote. The procurement plan should address quote-validity periods, long-lead equipment, approved alternatives and the point at which pricing can be secured.
JLL's 2026 U.S. Construction Perspective provides additional context on material costs, labor availability and regional construction conditions.
Contractor capacity can become a schedule constraint
Construction employment growth is estimated at 0.2% in 2026. Specialist contractor availability may therefore have as much effect on the schedule as the design or permitting process.
The project team should assess whether proposed contractors have the labor, technical knowledge and management capacity to meet the schedule. This is particularly important for projects that require specialized mechanical, electrical, technology or commissioning work.
Contractor conditions also vary by market. A national procurement strategy built on one cost and capacity assumption can produce different results across locations.
Technology infrastructure adds cost and coordination
Smart building systems, data infrastructure and AI-related building requirements account for an estimated 10% to 12% of total fit-out costs and these costs increased 8% year over year in 2026, according to JLL Research.
Technology scope affects more than the IT budget. It can change power, cooling, cabling, audiovisual, security and commissioning requirements. Those dependencies need to be coordinated with the building design and construction sequence rather than added after the main brief has been approved.
How risk profile changes by project type
When to bring in a specialist project manager

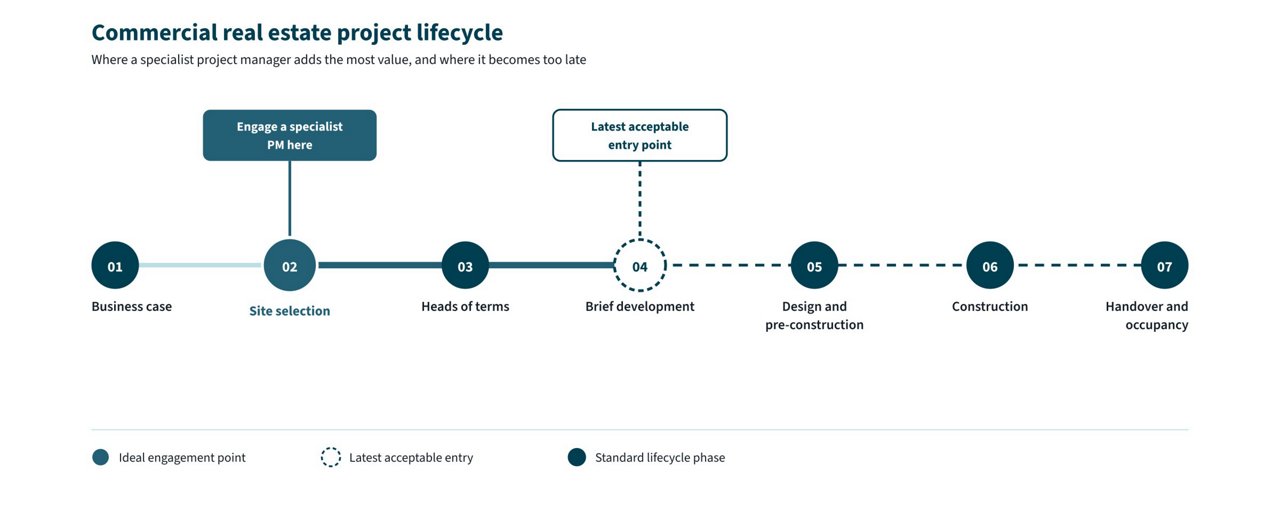

Real estate leaders who have delivered high-stakes projects successfully converge on one recommendation: engage the project manager before committing to a site, not after. Site selection is where a specialist adds the most value, because location decisions, cost baselines and procurement strategy are still open to change at that stage. Once the brief is locked and design begins, the financial decisions that determine the outcome have already been made.
What the right partner delivers at each phase
Good delivery on a high-stakes project unfolds as a sequence of decisions, and the setup at each step either reduces exposure or compounds it. Effective project and construction cost management stays invisible, since the project lands on time and on budget while attention moves elsewhere, while ineffective project management becomes visible to the board, to employees who cannot move in on the promised date, and to the person who owns the project and now fields every call.
Procurement is where financial value shows up most clearly
Hiring a specialist partner with capital planning expertise is critical for project success.Cost control begins with the brief, baseline and procurement plan rather than the first monthly construction report, so the largest cost and scope decisions must be made before construction starts.
These principles produced measurable results on JLL-managed projects:
- Zynga's 62,392 square-foot relocation delivered a 30% reduction in construction costs, plus a year of free rent and above-market tenant improvement allowances, from supplier relationships assembled before the project began.
- DigiKey's 2.4 million-square-foot warehouse expansion delivered $20 million in value engineering savings by applying the same procurement discipline at an order of magnitude larger scale.
- Advantis' headquarters consolidation delivered $2.1 million in savings using the same model at a mid-size scale.
Questions to ask when evaluating a specialist PM partner
For a high-stakes project, the question is longer about why you should hire a project manager, but how to ensure you choose a partner that meets specialist requirements and is properly vetted before onboarding.
Have they delivered the same type of project before?
Request case studies from the same industry and the same project type, not an adjacent one. Past delivery on comparable work predicts future delivery more reliably than any pitch.
Do you know who's accountable?
A single accountable team, rather than a network of subcontractors managed at a distance, is what makes on-time, on-budget delivery possible. Confirm who is responsible and how problems get escalated before signing.
Do they want to be involved before the brief is locked?
A capable PM partner insists on being in the room before the lease is signed. If they will only start once design is finished, treat that as a disqualifying signal: the biggest financial decisions get made upstream, before a design-stage engagement would ever reach them.
Do they govern cost, or just track it?
Ask how scope changes are approved, how contingency is managed, and what happens when the budget comes under pressure mid-construction. A partner who tracks a cost problem is not the same as one who prevents it, and only one of them protects the budget.
Is their supplier network genuinely competitive?
An established supplier program differs from a list of contractors someone has simply worked with before. Ask how procurement actually works, how savings are passed on to the client, and ask to see the numbers that prove it.
Organizations that consistently get complex projects right share one habit: they set the delivery model before the project starts, while the biggest decisions are still theirs to make.
Read the full High-Stakes Project Guide
Set the delivery model before project stakes rise
High-stakes real estate projects require more than standard delivery oversight. By identifying risk early, setting the right governance model and involving specialist project management before key decisions are locked, organizations can better control cost, protect operations and deliver with confidence.
